Skip to main content

Scheduled reports

The Reports tab of the Definition & members screen — of a project or a project portfolio — schedules an automatic email with a status of the scope. You choose the contents, the recipients and the frequency.

A portfolio produces a single email covering all its projects (archived projects are excluded), with one section per project.

Create a report​

  1. Open the project's Definition & members (or the portfolio's Definition / Members)
  2. Go to the Reports tab
  3. Click "New report"
  4. Fill in:
FieldPurpose
Report nameUsed in the email subject
ContentOne or more of the contents listed below
Alert margin (days)For deadlines: a task is reported as soon as its planned end is less than N days from its deadline (0 = overruns only)
Horizon (days ahead)For milestones, tasks without a resource and overload: the window looked at, from today
Age (days)For pending decisions/changes and status reports: beyond it, the item is reported
ThresholdsShown depending on the contents ticked: progress gap (20 points), overload (100%) and underload (50%) of capacity, risk criticality (high and critical, or critical only), budget alert (90%) and achievement / consumption gap (20 points) of a strategic plan. Values in brackets are the defaults, quoted in the tables below
RecipientsOne or more people of the workspace
Frequency, Day, TimeEvery day, every week (chosen day) or every month (day 1 to 28), at the time of your time zone
Do not send when the report is emptyAvoids a "nothing to report" email
ActiveUntick to suspend sending without deleting the report
  1. Save

You can create several reports on the same project or portfolio — for instance a weekly planning and budget report for management, and a daily overdue cards and actions report for the team.

Available contents​

GroupContentWhat is reported
PlanningDeadlinesOpen tasks whose planned end is after the deadline, within the margin of it, or whose deadline has passed
PlanningTasks behind scheduleOpen tasks whose planned end date has passed, with or without a deadline
PlanningTasks that should have startedTasks still Open although their planned start has passed
PlanningProgress behind scheduleOngoing tasks whose entered progress is at least 20 points behind the elapsed time
PlanningUpcoming milestonesOpen milestones falling within the horizon
AgilityOverdue cardsOpen cards whose due date — the deadline, otherwise the end date — has passed
StaffingTasks without a resourceOngoing tasks, or tasks starting within the horizon, with no resource assigned
StaffingOverloaded resourcesPeople in scope whose planned load, across all projects, exceeds their capacity over the horizon (workload screen computation)
StaffingMissing timesheetsPeople planned in scope last week who entered no actuals
GovernanceOverdue actionsOpen actions whose due date has passed
GovernanceOpen critical risksOpen risks of high or critical criticality
GovernancePending decisions and changesDecisions without a decision date and open change requests, pending for longer than the age
GovernanceProject status to updateProjects without a status report, or whose last one is older than the age
BudgetBudget overrunsEnvelopes whose forecast or actual cost exceeds the budget (same amounts as the budget dashboard)

Tasks, cards and milestones exclude parent tasks (except for deadlines): a summary task is not counted twice.

Resource portfolio​

On a resource portfolio, the Reports tab offers contents centred on the team's people. Each row is about one person, across all projects:

GroupContentWhat is reported
WorkloadOverloaded resourcesPlanned load above capacity over the horizon
WorkloadUnderloaded resourcesPlanned load under 50% of capacity over the horizon (available people)
WorkloadUpcoming absencesLeave and absences entered over the horizon, with the number of days (a half day counts 0.5)
TimesheetsMissing timesheetsPeople planned last week who entered no actuals
TimesheetsTimesheets not submittedPeople planned last week whose timesheet is neither submitted nor approved, or was returned
TimesheetsTimesheets to approveTimesheets submitted and not yet approved over the age window, with the oldest pending
DeliveryResources' tasks behind scheduleOpen tasks assigned to a team member whose end date has passed
DeliveryResources' overdue cardsOpen cards owned by a team member whose due date has passed

The summary at the top counts resources with alerts out of the resources analysed. Archived projects are ignored. Only the portfolio Owner (or a company administrator) creates and edits these reports; any portfolio member can view them.

Personal report​

In My profile, the Reports tab schedules a report on your own tasks and cards: those you own and those assigned to you, across all projects (archived projects excluded). Only you see and manage it; it is sent to you by default, and you can add other recipients (your manager, for instance).

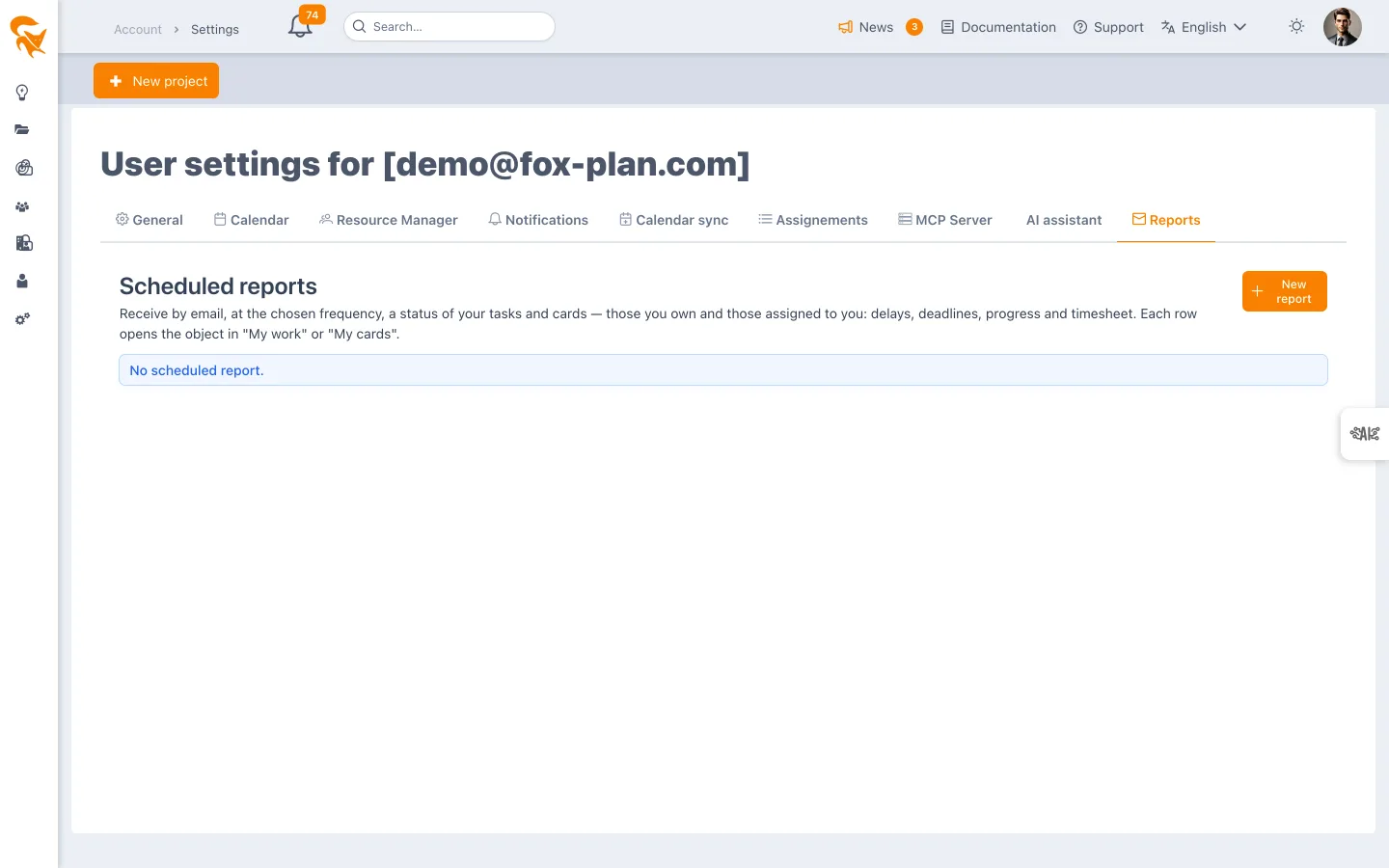

Reports tab of the user profile

GroupContentWhat is reported
OverdueOverdue tasks and cards I ownDue date (deadline, otherwise end date) passed
OverdueAssigned tasks behind schedulePlanned end date passed
Coming upDeadlines to watchPlanned end after the deadline, within the alert margin, or deadline passed
Coming upDue soonDue within the chosen horizon
Coming upProgress behind scheduleEntered progress at least 20 points behind the elapsed time
TimesheetsMy timesheetLast week neither submitted nor approved, with the actuals already entered

The summary counts the tasks and cards with alerts out of those you follow. Each row opens directly in the matching Me screen, ready to edit: a task in My work, a card in My cards, the timesheet in My timesheet.

Strategic plan​

On a strategic plan (Reports tab of the plan's Definition & members), the report combines contents specific to strategic management, computed on the current fiscal year with the same rollup as the Tracking screen, and all project contents, applied to the plan's projects (its list, or every project of the workspace when it is empty):

ContentWhat is reported
Objectives with a budget alertIn cost mode: forecast at 90% or more of the envelope (red above 100%). In revenue or margin mode: forecast under 90% of the target
Objectives with no contributing projectObjectives (leaves) with an envelope for the year that no project contributes to
Achievement behind spendingAchievement at least 20 points below consumption (actual / envelope, otherwise / allocated)
Plan projects with no contributionProjects in scope that contribute to no objective
Over-allocated projectsIn amount mode: amounts assigned to objectives above the project budget

An objective name opens the plan Tracking; a project name, its planning.

What the email contains​

At the top, a tile summary covers only the enabled contents: projects with alerts out of projects analysed, then — for deadlines — deadlines already passed, expected overruns and deadlines at risk (three exclusive categories), and one tile per other content. For overdue cards, a line adds the average and maximum delay and the three people holding the most.

Then comes a Resources section (overload, timesheets), then one section per project concerned, with its team (project admins and project managers) and one table per content. Every object listed is a link: a task or card opens in the planning or card board, an action, risk, decision, change or status report opens in its register with its detail panel, a budget overrun leads to the project budget, a project name to its planning. In a resource portfolio report, a person's name leads to the portfolio workload. The link works even when logged out: FoxPlan asks you to sign in, then opens the object.

Each recipient receives the report in their language, with their date format and their decimal separator.

A failing content does not block the email

If a content cannot be computed (for instance a misconfigured budget), the email is still sent with the other contents, and says so.

Send now, pause​

In the report list, the actions let you send now (without shifting the next scheduled send), pause / reactivate, edit and delete. The Next send and Last send columns show the state: Sent, Nothing to report or Error; hovering the last send shows the generation time.

Who can do what?​

ProjectPortfolio
View reportsAny member who opens Definition & membersAny portfolio member
Create, edit, send, deleteProject AdminPortfolio Owner (or company administrator)

The report runs with the rights of the last person who saved it: each content only covers the projects where that person can read the corresponding register (planning, actions, risks, budget…). If that person leaves the project or portfolio, or their account is deactivated, sending stops and the report switches to Error: another administrator just needs to save it again to restart it.

See also​
