Skip to main content

The project Dashboard

The Dashboard is a project's synthetic control panel: it gathers on one page blocks (indicators, charts, tables) that give an immediate view of progress, workload and budget. You reach it from the Dashboard menu in the project sidebar.

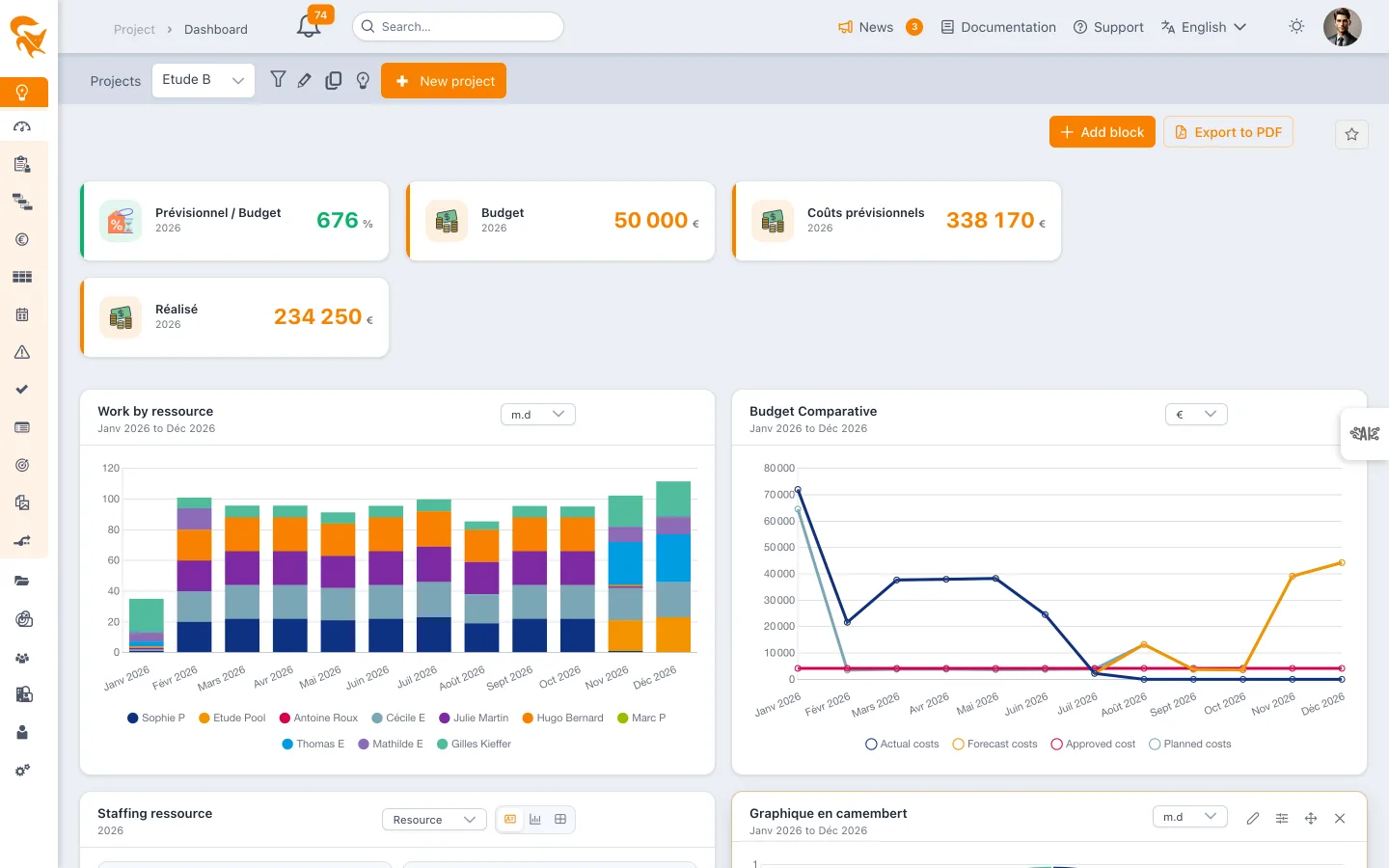

Project dashboard

The dashboard is fully modular: nothing is imposed, you assemble the blocks you need. The layout is saved automatically as you edit it.

The dashboard shipped when the project is created​

A brand-new project does not open on a blank page. It receives nine blocks right away, in its creator's language:

BlockTypeContent
ProgressTagThe overall % complete of the project
Project weatherTagThe overall indicator of the latest weather report
Forecast / ApprovedTagThe ratio of forecast costs to approved costs, over the current year
Approved budgetTagIn currency, over the current year
Actual budgetTagIn currency, over the current year
Work by resourceStacked BarMonthly workload, broken down per person
Budget comparisonLineActual, forecast, approved and planned costs, month by month
Deadline trackingTableThe tasks whose finish goes past the set deadline
Cards progressClassicOpen, in-progress, done and late cards

This dashboard is a starting point, not a fixed template: every block can be renamed, moved, reconfigured or removed, and others added. The same set of blocks is laid down when a project is cloned and on a bulk import.

The same content is also shipped to the workspace as a shared favorite — "Project dashboard (default)" — assigned to the default groups: any project whose dashboard is empty displays it right away, and everyone finds it in the favorites menu. See Default dashboards.

The action bar​

ActionEffect
Add blockOpens the 3-step creation wizard (block type → content → configuration)
Open draftSwitches to draft mode: changes are no longer saved
Export (download icon) → Export to PDFGenerates a printable image of the whole page
Export (download icon) → Export to PowerPoint (.pptx)Generates an editable PowerPoint presentation: indicators as cards, charts as native PowerPoint charts
★ FavouritesSaves / reloads a named dashboard layout

Adding a block​

Step 1 — The block type​

TypeUse
Tag (indicator)A single value and its unit: budget, margin, % complete…
LineEvolution over time of one or several dimensions
BarPeriod-by-period comparison
Stacked BarBreakdown of a total (typically workload by resource)
PieDistribution over a period, with no time axis
ClassicResource staffing and task tables

Step 2 — The content​

Choices are grouped by family — Tracking, Costs, Revenue, Margins, Ratios, Planning, Resources, Cards, Risks — and each comes with a sentence saying what it measures (for example Planned costs: “Derived from resource allocations on tasks”). Budget dimensions always read from approved to actual. A search field filters the list; it also searches these explanations: typing “time entries” finds the actual dimensions.

For a chart, the choice is made through two tabs:

  • By dimensions — tick one or several budget dimensions; each becomes a series of the chart. This is how you build a budget comparison, by ticking for example Approved cost, Forecast costs, Planned costs and Actual costs.
  • By resources — one series per resource (workload in cost or in revenue).

Available dimensions:

FamilyDimensions
CostsApproved cost, Forecast costs, Planned costs, Actual costs
RevenuesApproved revenus, Forecast revenus, Planned revenus, Actual revenus
MarginsApproved margin, Forecast margin, Planned margin, Actual Margin

For a tag, choose the value to display: one of the dimensions above, a ratio (Forecast costs / Approved cost, Forecast revenus / Approved revenus), the project weather, the overall progress or the Number of resources — the people allocated to at least one task in the scope (leave does not count; on a team dashboard, only team members are counted).

For a classic block, choose between Resource staffing and the tables: Task list, Milestone list, Tasks and milestones list, Deadline tracking, Tasks with a predecessor in another project.

The Task list and Deadline tracking blocks carry a Tasks · Cards · Both selector at the top. By default they list the planning tasks; on Cards they track the stories, bugs and sub-tasks of the scope with the same ordering rules; on Both the two are mixed and a small icon marks the cards. A closed card counts as done. The choice is saved with the block: it survives a reload and follows the block into a favorite.

Step 3 — The configuration​

This screen determines over which period and in which unit the block is computed.

SettingDetail
Unit€ (the workspace currency) or m.d (man-days)
Period typeMonth, Year or Variable
Cumulative valuesDisplays the series as running totals (see below) — time-based charts only
Month granularityOn a period in years, splits the axis month by month instead of year by year

Depending on the period type:

  • Month — From month … / to month … bounds
  • Year — From year … / to year … bounds
  • Variable — the period is recomputed every time the dashboard opens, relative to today's date. You define it with a time unit (Month or Year), an operator and a number of periods:
OperatorResulting period
CurrentThe current month or year
PreviousThe N periods before today
NextThe N upcoming periods
Previous and nextThe N past periods and the M upcoming ones
Fixed or variable period?

A variable period saves you from reconfiguring the dashboard every year: Year / Current always shows the current financial year, Month / Previous and next 3 and 3 keeps a sliding window around the present month.

Cumulative values​

The Cumulative values option turns each series into a running total: every point carries the sum of all the points before it. The curve becomes monotonically increasing — the classic S-curve of project tracking.

  • Without cumulation — the consumption of each month. You read activity peaks and quiet months.
  • With cumulation — the total consumed since the start of the period. You read the widening gap between budget and actuals, and the last point of each curve equals the period total.

The typical use is a Cumulative Budget block: a line chart with the four cost dimensions and the option ticked, next to a non-cumulative Comparative Budget. The first shows the trajectory, the second the pace.

The option is available on line and bar charts (simple or stacked), for month periods as well as year periods. It makes no sense on a pie chart, which has no time axis, and is therefore not offered there.

Managing blocks​

Hovering a block reveals an icon bar:

IconAction
✕Delete the block
☰Move the block by drag and drop
✎Reopen the configuration screen (period, unit, cumulation)

Each block title can be edited inline: hover it, click the pencil, type the label of your choice and confirm with the green tick. This is how you name a block Comparative Budget or Cumulative Budget.

Charts additionally offer a unit selector (€ / m.d) in the top-right corner, which recomputes the block without going back through the configuration.

The Resource staffing block has its own grouping — by Resource, Department, Team, Position, Profile or Company — and three displays: table, chart and cards.

Draft mode​

As for the budget, a draft lets you work on a copy of the dashboard without saving the changes — handy to prepare a presentation or a one-off export.

  • Open draft: changes are no longer persisted.
  • Close draft: back to the real data.

Favourites​

The ★ control saves the current layout under a name. You can keep several dashboards for the same project — a "budget tracking" one, a "steering committee" one — and switch between them.

A favourite can be shared with the other users of the workspace. A shared favourite you do not own opens in read-only mode: you can manipulate it on screen, but your changes overwrite neither the favourite nor your own dashboard.

Exporting​

The download icon, left of the favorite, offers "Export to PDF", which generates a printable version of the dashboard, ideal for a steering committee or a periodic report.

It also offers "Export to PowerPoint (.pptx)", which produces a presentation ready to show and editable: a cover (title, project or portfolio, date), a slide of indicators (one card per tile, values rounded as on screen), then one slide per block. Bar charts (plain or stacked), line, pie and doughnut charts become real PowerPoint charts with their data: you can recolour or complete them in PowerPoint. The other blocks (bubbles, weather, risk matrix, burndown, tables) are included as images, without the card's buttons.

See also​

Good habit

Build a stable dashboard for recurring tracking, and use the draft for one-off views (e.g. a budget focus for a committee) without altering the reference layout.
