Skip to main content

Planning

The Planning screen is the project's Gantt view: this is where you build the structure of tasks and milestones, set their dates and dependencies, and assign resources. You reach it from the Planning menu in the project sidebar.

Depending on project type
  • Gantt (planned) — the screen offers a full planning experience: WBS, dependencies, constraints, auto schedule, baselines.
  • Kanban / Scrum — the screen is still available. For these projects, day-to-day work is rather driven from Card & Story.

Anatomy of the screen​

The screen is made of three areas:

  • The toolbar at the top — add, edit, move, zoom, filter and export
  • The task grid on the left — the task tree and its columns
  • The Gantt chart on the right — time bars, dependencies, baselines and resources

A side edit panel opens when clicking a task to edit its attributes without leaving the screen.

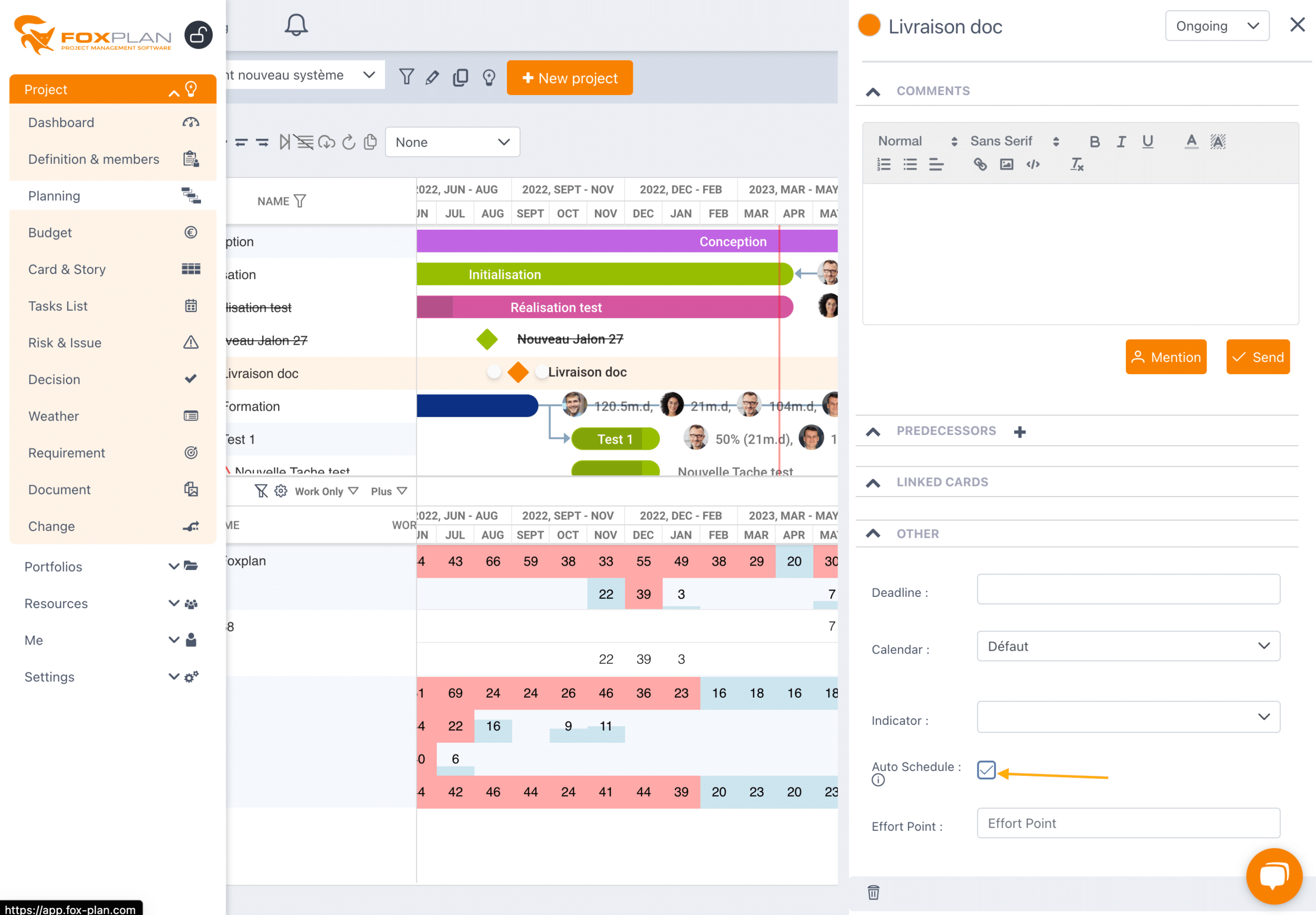

Planning overview: task grid, Gantt chart and edit panel

The toolbar​

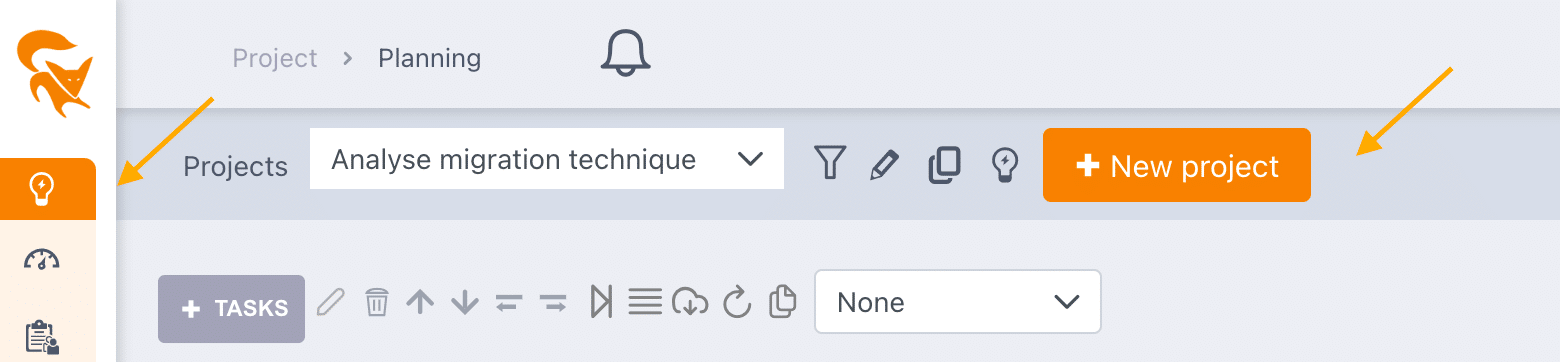

Planning toolbar with the "+ Task" button and the editing actions

Create and edit​

  • + Task — main button to add a task or a milestone (context menu on click)
  • ✏️ Edit the selected task — opens the full editor
  • 🗑️ Delete the selected task (confirmation required beyond a single task)
  • ⬆️ / ⬇️ Move the task up or down in the list
  • ⬅️ / ➡️ Indent / outdent the task (create or break a subtask)

Organize the planning​

  • ⏭️ Shift the project — shifts every task by setting a new project start date
  • ☰ Run auto schedule — applies the auto schedule to the relevant tasks (shown when at least one manual task needs to be recomputed)
  • ☁️⬇️ Import tasks from a template — inserts the content of a template project into the current project
  • 🔁 Refresh the planning data
  • 📋 Copy tasks — opens a dialog to copy one or several tasks (with their allocations, comments and linked documents) into the current project or to another project → see Copy tasks
  • 🔽 Bulk import of tasks — tabular entry to create many tasks at once
  • 🔍 Search / filter a task — drop-down listing every task in the project
  • ↶ / ↻ Undo / Redo — revert the last changes (tasks and assignments), then replay them → see Undo and redo

Alert indicators​

On the right side of the toolbar, FoxPlan shows alert badges about task health:

  • ⚠️ Tasks to close — tasks whose end date has passed and that are not done
  • ⚠️ Late tasks — ongoing tasks whose expected start or progress is not met
  • 🔖 Tasks with a remaining workload (RAF) to refresh

Alert badges: tasks to close, late tasks and remaining workload to refresh

Clicking a badge opens the detail of the matching tasks.

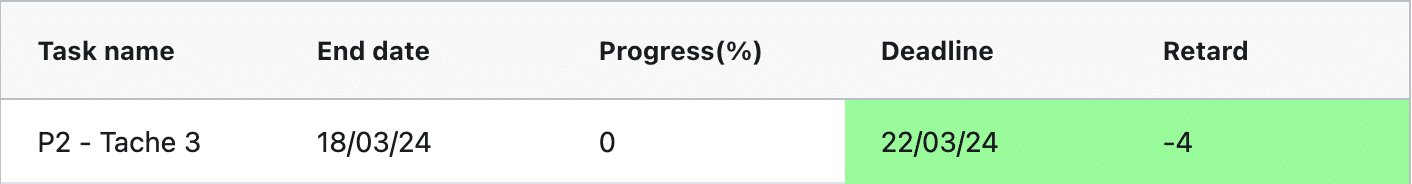

Detail of tasks in alert (deadline and delay)

Zoom and visualization​

  • Zoom — switches the time scale: Year / Quarter / Month / Week / Day
  • 🪪 Resources panel — opens a side panel to drag and drop resources onto tasks
  • 🗺️ Planning view — toggles between Gantt and resources view
  • 👥 Performance mode — hides resources to speed up the display of very large plannings
  • 👁️ Show / hide the chart — only displays the task grid
  • 📅 Display period — limits the Gantt view to a date range
  • ⛶ Fullscreen
  • ⚙️ View settings — columns, baselines, display options (see below)

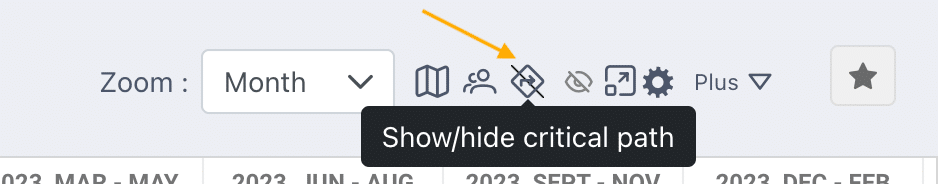

Zoom selector and visualization icons (critical path, resources, fullscreen, settings)

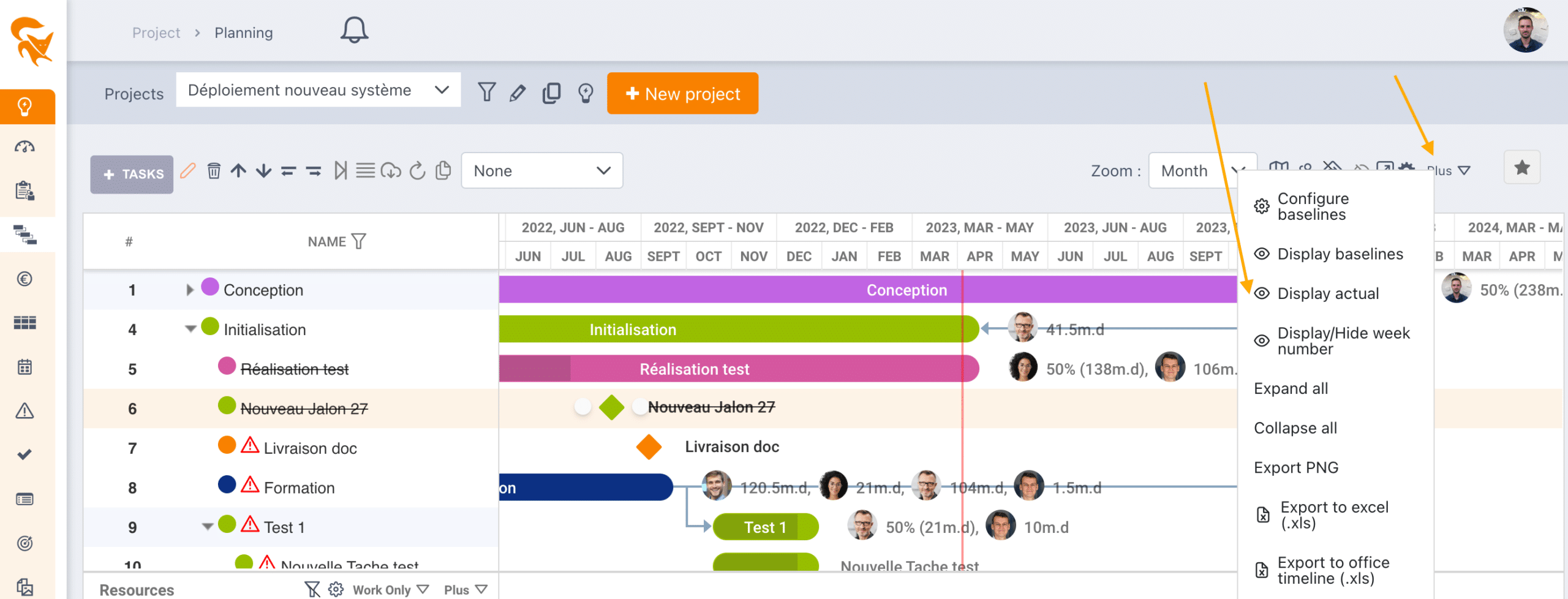

The "More" menu​

The More button gathers the secondary actions:

  • Expand all / collapse all — unfolds or folds the task tree
  • Import an MS Project file (.mpp, .xml, .mpx, .mpd) — only dates and dependencies are imported, not resources

Exports​

The download icon, between More and the favorite, gathers every export: PNG, PDF, Excel, CSV, MS Project and Project planning (.pptx).

Export the plan to PowerPoint​

Project planning (.pptx) builds a PowerPoint presentation of the planning as displayed: the rows expanded on screen (a collapsed phase appears alone), in the view's order and with its filters. Each row is indented by level, with its dates; phases are drawn as a thin bar, tasks as a bar in the Gantt colour with the completed part darker, milestones as diamonds, deadlines as arrow badges and dependencies as arrowed connectors. Beyond 14 rows, the planning continues on further slides. Every shape is native PowerPoint, so it can be edited; the resource grid (lower part) has its own export, described below.

Export the workload to PowerPoint​

In the resource grid (lower part of the screen), the header's More menu offers Workload export (.pptx). It builds a PowerPoint presentation of the resource grid, as editable native tables: one row per resource, one column per period of the displayed scale, plus the total. Each cell mirrors the on-screen display — "workload/capacity", workload only or percentage, depending on the cell display options — on a red background when overloaded (planned > capacity) and blue when the planned workload fits within capacity; a legend explains the colours. Beyond 20 resources or 12 periods, the table continues on further slides. The figures are the same as in the Excel export.

Favorites​

The Favorite selector on the far right lets you save a combination of filters, columns and zoom to replay it in one click.

Create tasks and milestones​

When clicking + Task, a menu offers:

  • Add a task — planned item with start, end, duration and resources
  • Add a milestone — checkpoint without duration

When creating / editing a task, you fill in among others:

  • Name (required)
  • Start date, end date, duration
  • Progress (% or actual / remaining)
  • Assigned resources and allocations (% or man-days)
  • Predecessors (dependencies) and link type (FS, SS, FF, SF) with lag
  • Scheduling constraint (see Project management)
  • Deadline, priority, status, description

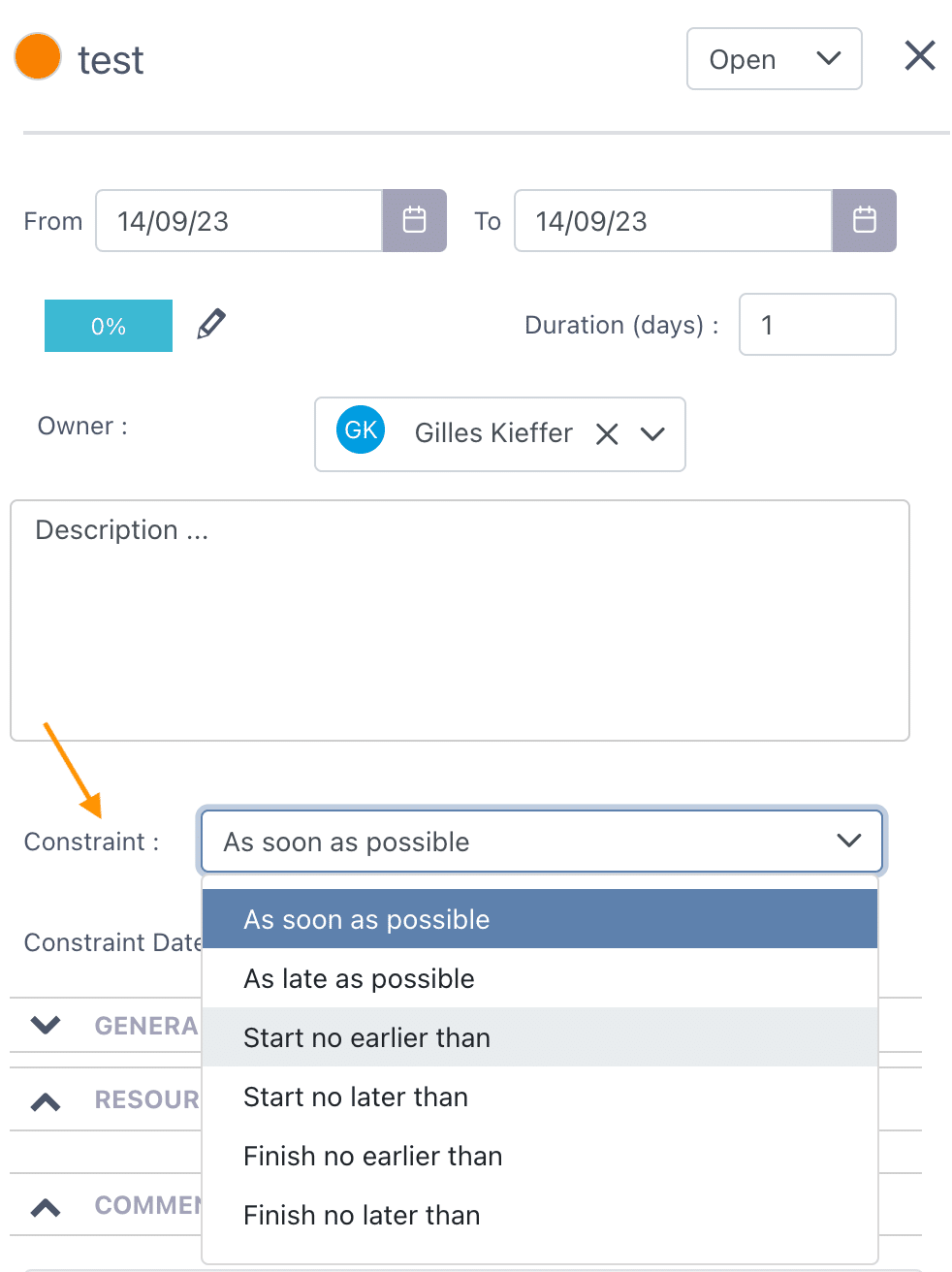

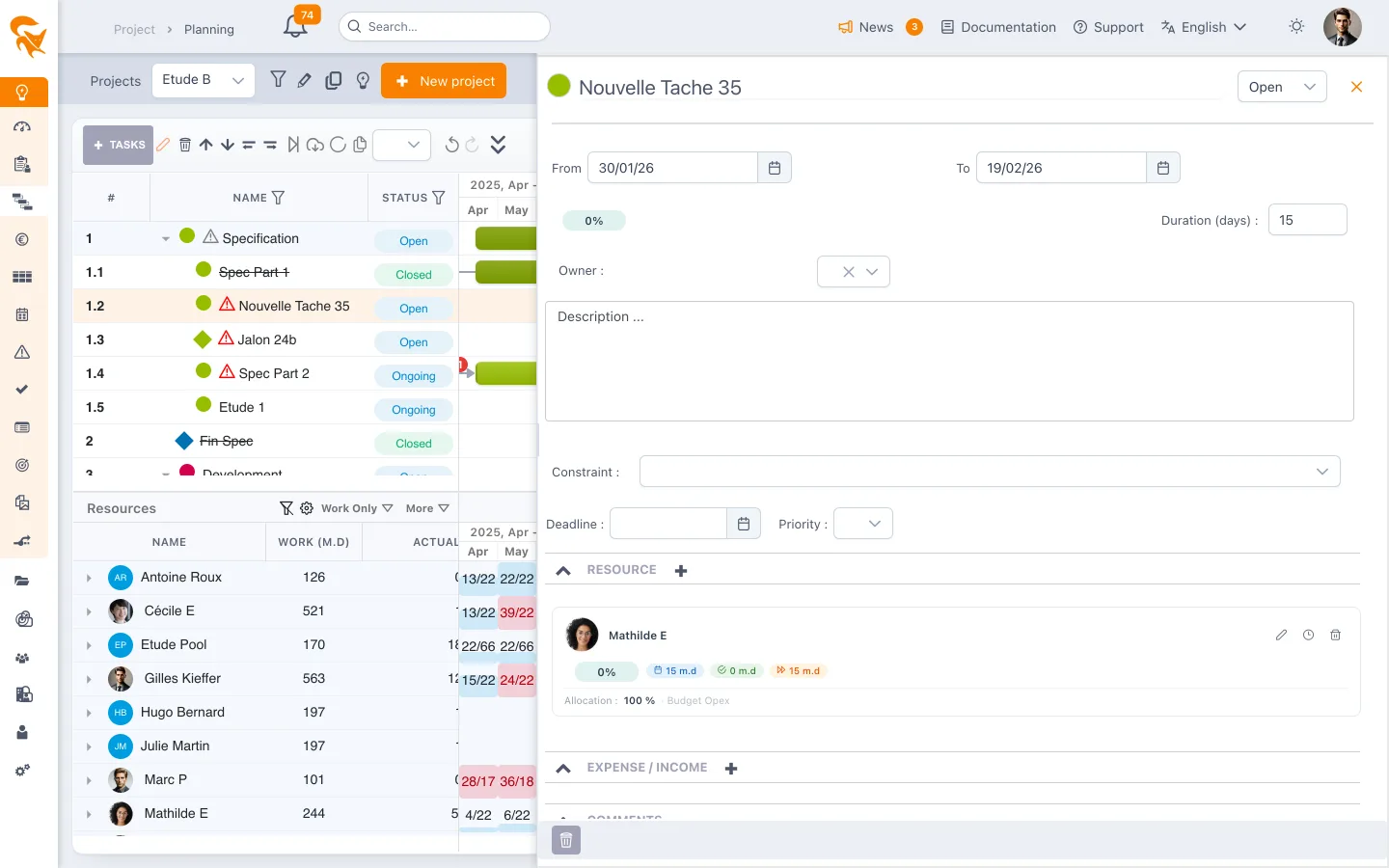

Task edit panel: dates, progress, owner and scheduling constraint

Dependencies​

Dependencies are created visually in the Gantt (drag between two bars) or via the edit panel. FoxPlan supports the four classic links:

LinkMeaning
Finish → Start (FS)The next task starts when the previous one is finished (default)
Start → Start (SS)Both tasks start at the same time
Finish → Finish (FF)Both tasks end at the same time
Start → Finish (SF)The end of the next is tied to the start of the previous

A lag (positive or negative, in days) can be applied to each link.

Assign resources​

Three ways to assign a resource to a task:

  1. From the task edit panel, add an allocation and enter a percentage or a number of man-days
  2. Drag and drop from the Resources panel (🪪 icon in the toolbar) onto a Gantt bar — a small form then asks for % / man-days and the budget to charge against if several are available
  3. Bulk assign on several selected tasks via the context menu

The resources panel shows for each member their workload percentage over the visible period, with a color code (under-load / load / over-load).

Task actual type​

If the workspace has several actual types active, the task edit panel shows an Actual type field, next to the priority.

  • Empty ("Inherited from the envelope"): the task uses the type of each allocation's budget envelope.
  • Set: this type takes precedence over the envelope's — useful for a non-billed phase (warranty, internal acceptance testing) within a billable envelope.

It is the type offered by default in the timesheet of the assigned resources. As long as a resource has entered nothing, their line follows the task's type; as soon as they have entered time, their choice prevails.

Auto schedule​

Auto schedule automatically recomputes the task dates while respecting their dependencies and constraints. It is enabled task by task, in the Other section of the edit panel.

A task with no predecessor has the As soon as possible constraint by default: it is placed as early as possible, i.e. at the start of its phase. When you drag it in the Gantt, its constraint becomes Start no earlier than, set to the date where you dropped it: the task stays there, including after a reload. A predecessor still takes precedence: the task cannot start before it. To move it back to the start of its phase, set its constraint back to As soon as possible in the edit panel.

When a change triggers a pending recompute, a ✅ Validate and ❌ Cancel button appear on the right side of the toolbar: you preview the effect before saving.

The default settings (auto-schedule on or off for new tasks) are configured under Definition & Members at the project level.

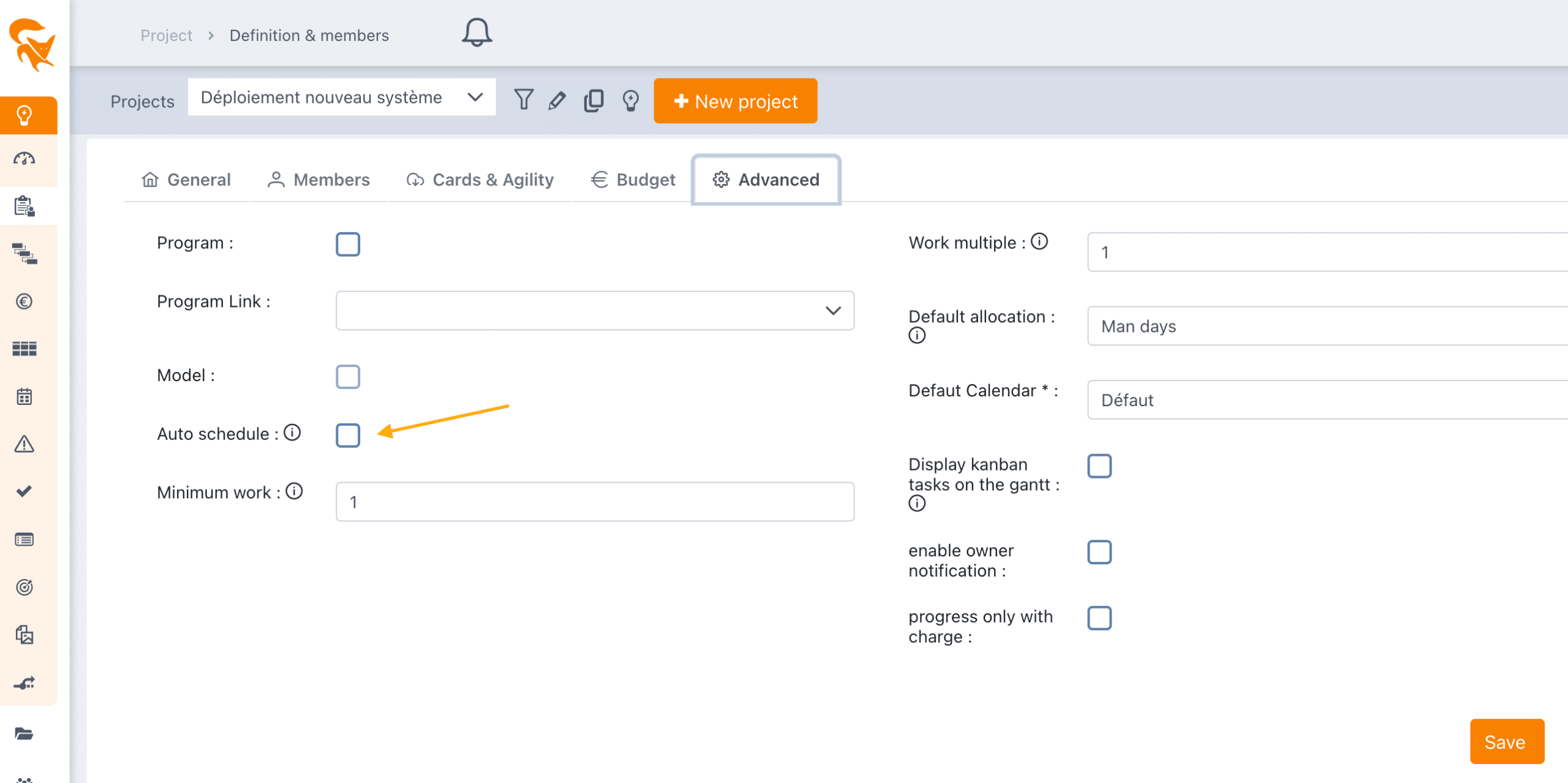

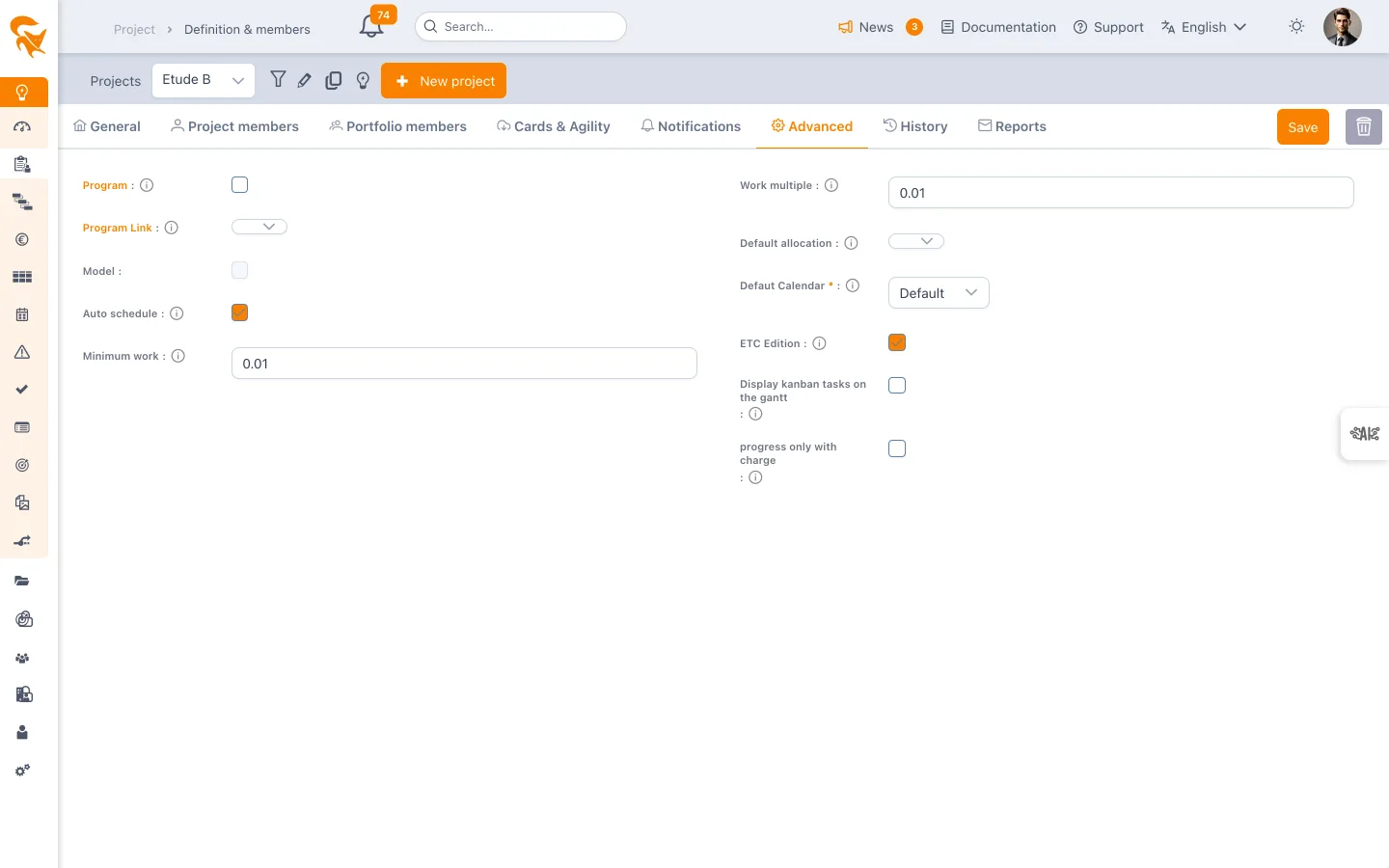

Project definition Advanced tab: default "Auto schedule" option

View settings​

The ⚙️ icon opens a dialog with three tabs:

Columns​

Selects the visible columns in the left grid (Name, Start, End, Duration, Progress, Resources, Budget, custom fields, etc.). Order and width are memorized and can be saved in a favorite.

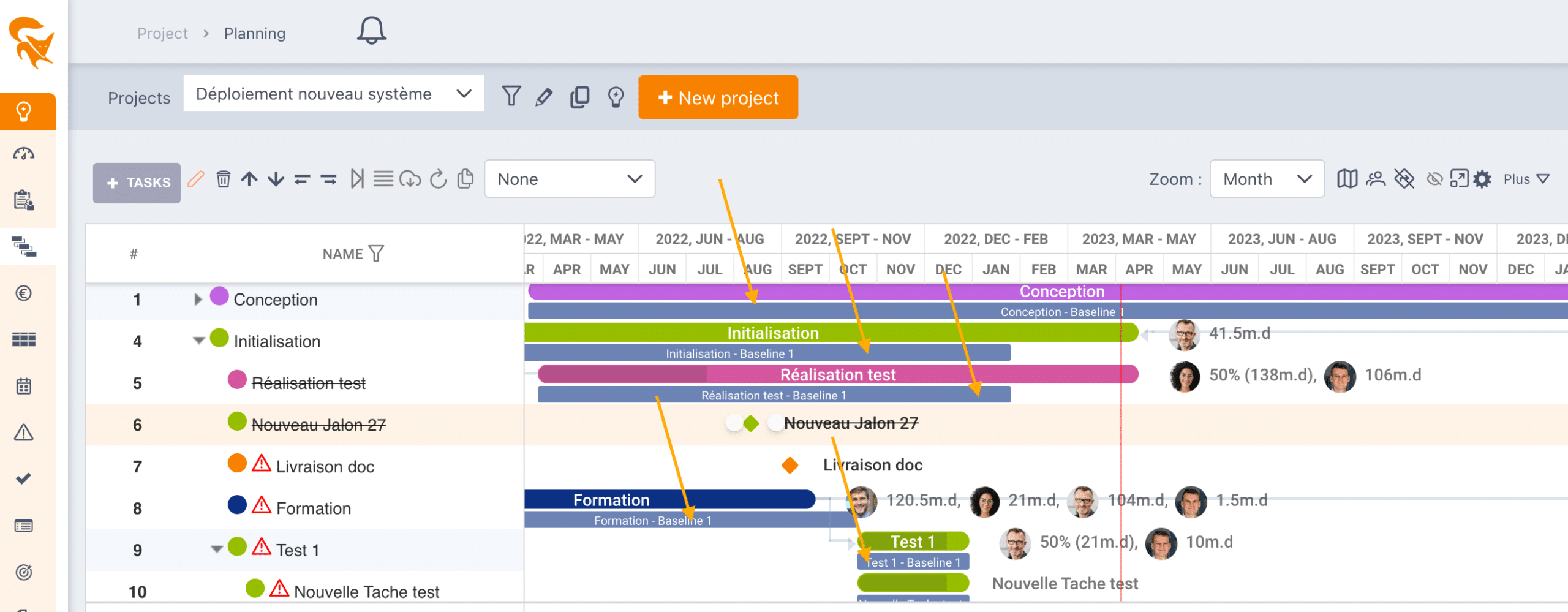

Baselines​

A baseline is a snapshot of the planning at a given point in time, useful to compare the initial planning with the actual.

  • Show / hide the active baseline in the Gantt
  • + Add a baseline — label + date
  • Choose the baseline visible at portfolio level (radio)
  • 🗑️ Delete a baseline

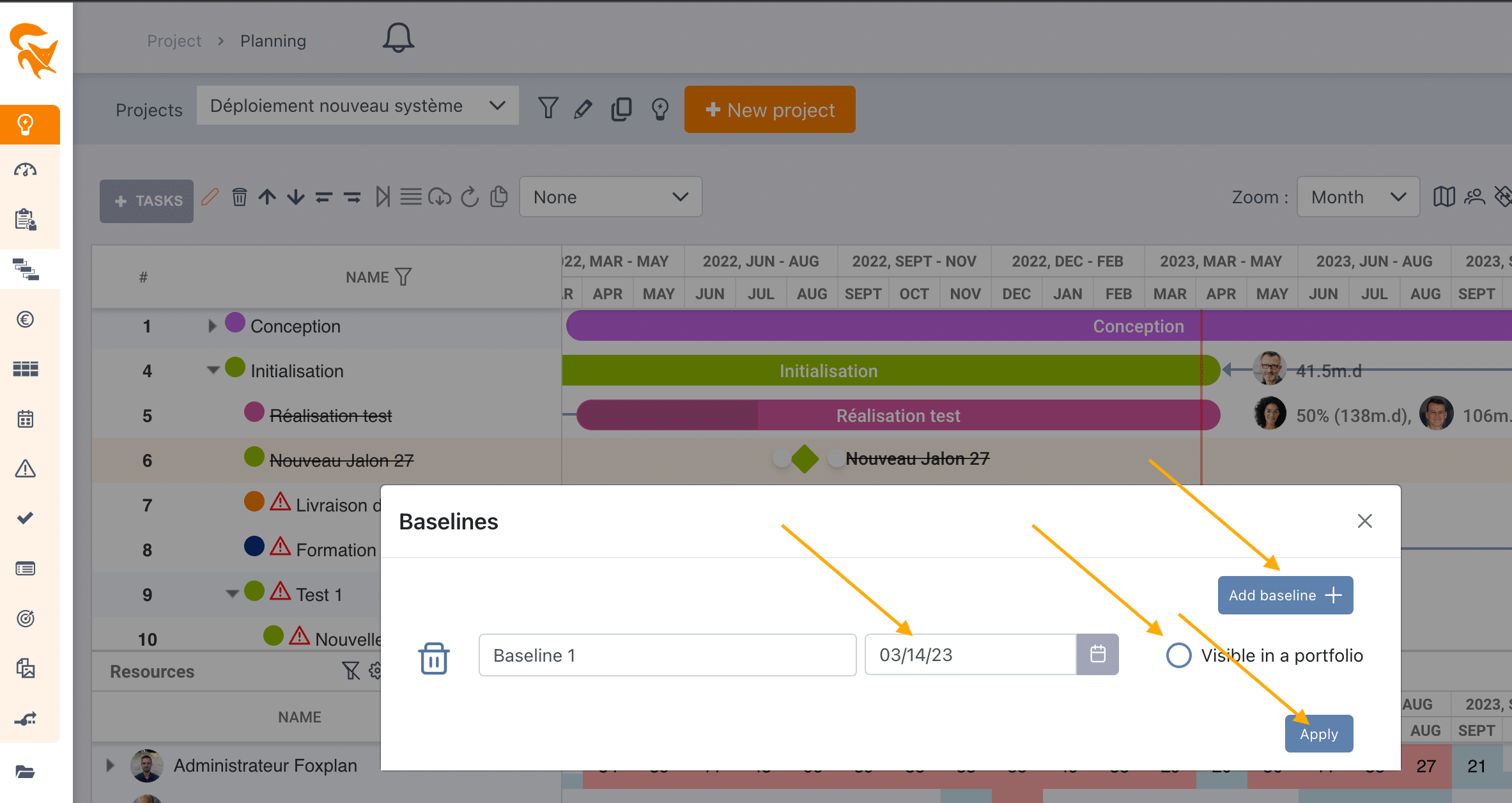

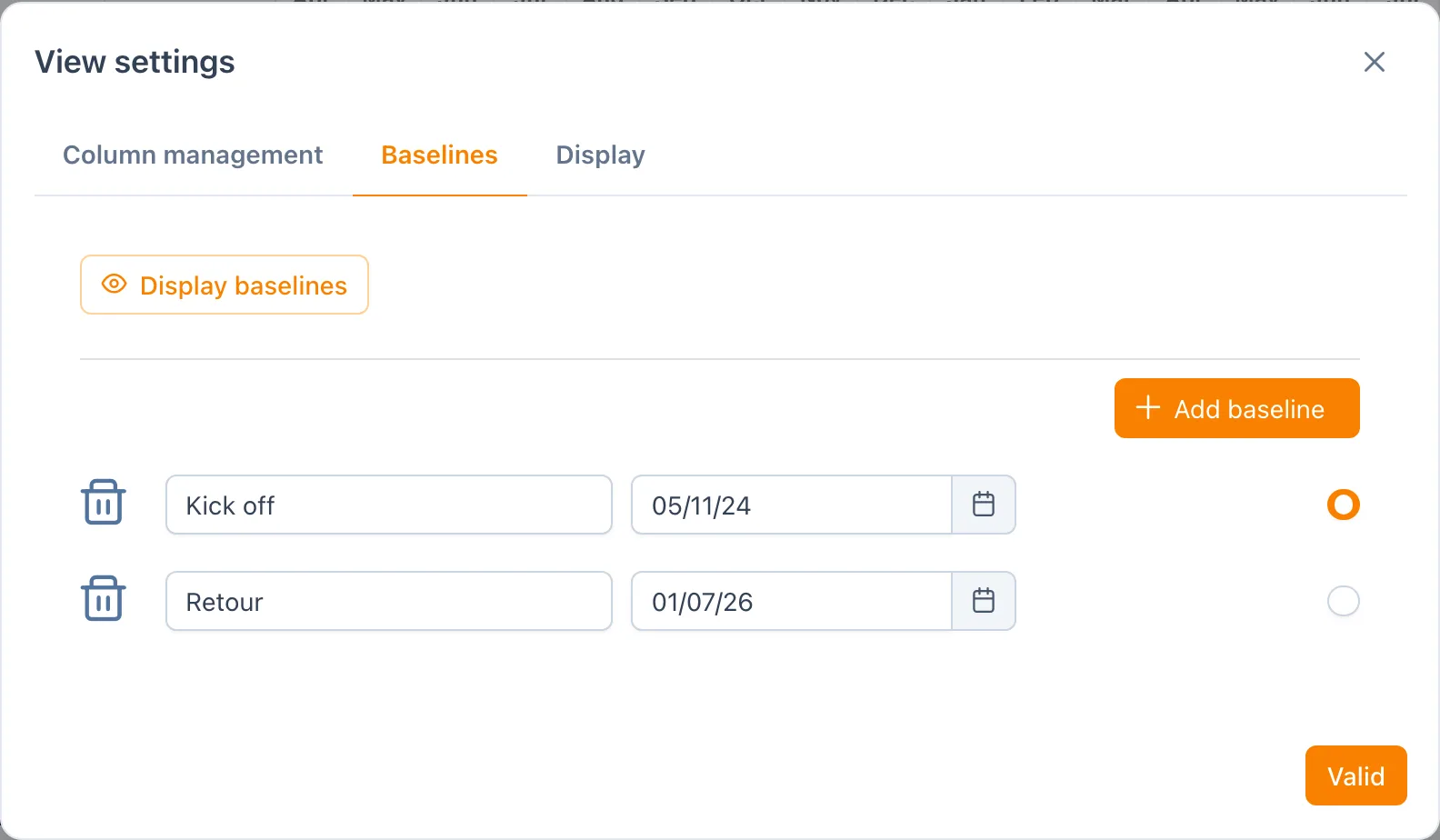

Baselines dialog: adding a baseline with a label and a date

Visualize​

Toggle the display of:

  • Actual — overlay of real progress on the bars
  • Critical path — highlights the sequence driving the project end date
  • Week number in the time scale
  • Avatar of resources on the bars
  • Alerts (delays, missed deadlines)
  • Search by task name in the toolbar drop-down
  • Advanced filters via favorite: by owner, by status, by period, by custom field
  • Display period (📅 icon) — restricts the visible time window
  • Indicators ⚠️ — a click isolates tasks in alert

Jira synchronization​

For a project linked to Jira, a Start sync button shows in the toolbar. It triggers a two-way import / export of tickets and their status.

Permissions​

Editing the planning follows the member's role in the project:

RolePlanning edition
Project Admin✅ Full edit
Project Leader✅ Full edit
Reader👁️ Read-only
Resource👁️ Read-only (can update progress on their own tasks if the workspace allows it)

Full details in Project members.

Resource grid totals​

In the Resources area (bottom of the screen), each resource row shows the total of its allocations on this project's tasks, for every numeric column (Planned, Actuals, ETC, Δ ETC, custom fields…). The “Other projects” row is not included in these totals.

See also​

Good habit
